Construction Update: The Municipality of Anchorage (MOA) Project Management & Engineering Department (PM&E) is preparing to begin construction of the Quinhagak Street Reconstruction project from E. Dowling Road to Askeland Drive (see map below for project limits). Construction will begin in late May or early June, depending on when seasonal weight restrictions are lifted. Work is tentatively anticipated to begin at E. 64th Avenue.
MOA selected Mass Excavation, Inc. (MASS) to perform the construction of this project through the public bidding process. MOA and MASS’s contact information is provided on the Comment page. Additional construction information is provided on the 2026 Construction Announcement under Recent Project News.
The MOA is planning to upgrade Quinhagak Street between East Dowling Road and Askeland Drive.
Improvements will include:
- New road foundation
- New asphalt pavement
- New curb & gutter
- New storm drain system
- New pedestrian facilities
- New street lighting
MOA PM&E has contracted with CRW Engineering Group, Inc. (CRW) to provide engineering and design services.
How to get involved:
- Sign up for e-mail updates by clicking the link at the bottom of this page.
- Contact us anytime with comments or questions at justin.keene@crweng.com
Recent Project News

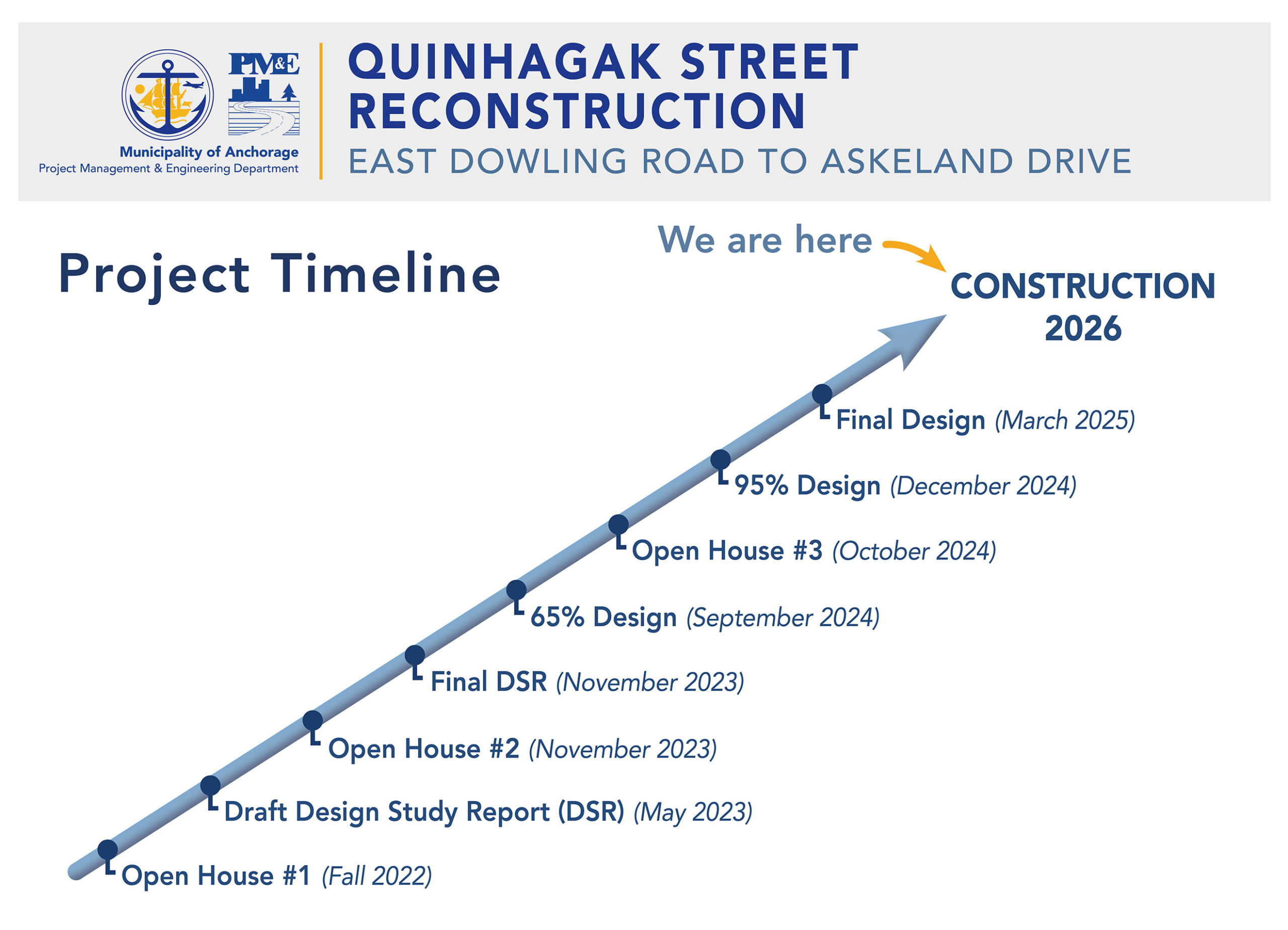

Current Project Schedule
UPCOMING MEETINGS
No meetings scheduled at this time.
PAST MEETINGS & DOCUMENTS
May 2026
Construction Announcement
June 2025
Construction Announcement
Map of the Project Area
